Permit Scope, Approved Plans, and Field Revision Control
July 7, 2026
Test Your Knowledge
12 questions · Audio-based · Study on the go
Audio Quiz
Questions are read aloud. Tap to start — works with your phone in your pocket.
Use the official CSLB B General Building guide as the exam map while you practice this topic with the audio quiz.
This is practical, audio-first exam prep for people studying around real work. Lessons and quizzes are built from official and reputable sources, then shaped into focused review you can use on the go.
This content is produced by Pass The CSLB, an independent audio-first study companion for busy California B General candidates. I build these lessons from official CSLB study-guide topics and reputable source-backed California materials so you can study on the go. This is exam-prep reinforcement, not legal, professional, engineering, or job-specific advice. Exam content is set by PSI and the CSLB and may change, so always verify current requirements against official CSLB materials. No exam outcome is guaranteed. Now let's get into it.
This episode covers permit scope, approved plan sets, jobsite document retention, field changes, revision clouds, delta symbols, amended construction documents, and the California Building Code Sections 105.2, 105.7, 107.3.1, 107.4, and 110.5, because this is where code compliance turns into daily field supervision.
I want you to think of a permit as permission for a specific story, not permission for construction in general. The city is not saying, go build whatever seems reasonable. The city is saying, based on this application, this address, this scope, this plan set, this engineering, and these code checks, this specific work is approved to move forward. That difference sounds administrative, but it is the whole ballgame.
Based on the published California contractor study outline, scope of work and code compliance sit inside planning and estimating. That makes sense. Before a contractor can estimate, schedule, sequence, or call an inspection, I have to know what work is actually authorized and what document controls the job. A lot of expensive field problems start with 1 sentence that sounds harmless. Somebody says, it is basically the same. In permit work, basically the same can be miles away from approved.
Permit scope begins with a broad idea. In California building administration, construction, alteration, repair, movement, demolition, occupancy change, and related work generally require application to the building official before work starts, unless the code or the local authority gives an exemption. I am saying that carefully because local rules matter. A California city or county is the authority having jurisdiction for most ordinary building permits, and that authority can have local amendments, forms, policies, and submittal procedures.
The useful exam prep distinction is not just permit or no permit. The useful distinction is authorized scope. A permit has edges. A bathroom remodel permit does not automatically authorize a load bearing wall change in the next room. A reroofing permit does not automatically authorize a new patio cover. A plan that shows 1 window size does not automatically authorize a different opening because the rough opening looked easier in the field.
Here is my working definition. Permit scope is the boundary of work that the building department reviewed and allowed. Approved plans are the map of that boundary. The inspection is where the inspector compares the actual work to that map. When the work and the map do not match, the job needs an approved explanation before that change becomes code compliant.
That is why I call the approved plan set the legal baseline. It is not just a drawing. It is the measuring stick. A tape measure tells you whether a wall is 8 ft. long. The stamped plan tells the inspector whether that wall belongs there, carries load, affects egress, changes a fire assembly, or matches the energy and structural assumptions used in plan check.
A good superintendent already knows the job from experience. The licensing exam is not asking the contractor to forget field judgment. It is asking the contractor to put field judgment in the right lane. You can notice a conflict, protect the work, stop the affected area, and coordinate the question. But you do not get to silently rewrite the approved scope.
Now I want to handle 1 of the biggest traps in permit questions, and frankly 1 of the biggest traps in real construction. The trap is thinking that exempt from permit means exempt from code. That is false. California code language is very direct on this concept. Work that is exempt from the permit requirement does not get permission to violate the building code or other applicable laws and ordinances.
I want you to memorize the sentence this way. No permit required does not mean no rules apply. Say that like a jobsite warning label. No permit required does not mean no rules apply.

Looking at this chart, I put the common exemption examples side by side because the numbers are easy to confuse. Residential fences not over 7 ft. high are generally listed in the residential code permit exemptions, subject to local changes. Retaining walls that do not retain more than 4 ft. of material, measured from the bottom of the footing to the top of the wall, are generally exempt unless they support a surcharge. Nonfixed and movable cases, counters, and partitions not over 5 ft. 9 in. high are generally listed in the building code exemptions. The point is to separate a permit trigger from code compliance.
Think about a retaining wall after a heavy rain. A contractor tells the owner, this is under the permit threshold, so I can build it however I want. That is the exemption trapdoor opening under his feet. Soil does not care that a permit was not required. Hydrostatic pressure does not care. A surcharge from a driveway, slope, footing, or stored material does not care. If the wall fails onto a sidewalk, the defense cannot simply be, I did not need a permit. The better habit is to ask 2 questions. 1st, does this scope require a permit here. 2nd, even if it does not, what code, zoning, drainage, setback, manufacturer, engineering, or local requirement still controls the work.
The fence example works the same way. A 6 ft. fence may sit inside a general permit exemption, but it can still run into local height limits, wind exposure, pool barrier rules, property line disputes, and homeowner association restrictions. The building code exemption is not a magic eraser.
That distinction protects you on the exam and on the job. If a question gives you an exempt item and then offers an answer that says the contractor can ignore code, that answer should smell wrong immediately. The safe principle is simple. Permit exemption is not law exemption.
Now I want to move from permit scope to approved plans. When the building official issues a permit, the construction documents are approved in writing or by stamp as reviewed for code compliance. That stamp matters. Before approval, a drawing may be a design proposal, a progress print, or a coordination document. After approval, the returned approved set becomes the field enforcement document.
I call it the golden set. Not because it is pretty. I call it the golden set because it is the set that controls. The golden set is the authority having jurisdiction stamped plan set returned to the applicant and kept at the work site, open to inspection.
The code creates a practical 2-set system. 1 set stays with the building official as the official record. 1 approved set comes back to the applicant and stays at the site. For certain dwellings not more than 2 stories and a basement in height, the building official also has plan retention duties. The jobsite part is the 1 I want you to keep sharp. The inspector should not have to guess, rely on memory, or accept an unstamped progress set.
Imagine an inspector arriving for a rough framing inspection. The crew has a clean architectural print from before plan check comments were added. It looks professional, but if it is not the approved set, the inspector has a problem. The city may have required corrections, engineering notes, hold downs, or fire comments. Without the stamp and approved notes, the inspector does not have the legal baseline.
This is why the building permit or a copy of it also has to be kept on the site until completion. The permit card and the stamped plans are like the passport and itinerary for the job. The card proves legal authorization. The plan set says where the job is allowed to go.
I want to slow down on jobsite retention because it is easy to treat it like paperwork, and it is not just paperwork. California Building Code Section 107.3.1 requires the returned approved construction documents to be kept at the site and open to inspection. California Building Code Section 105.7 requires the permit or a copy to be kept on site until completion. California Building Code Section 110.5 puts a duty on the permit holder to provide access to and means for inspections.
That means the contractor is not only building the work. The contractor is also staging the inspection environment. If the inspector needs the approved plans, they must be available. If the inspector needs safe access, the permit holder provides access and means for inspection. If the stamped plans are locked in the office 30 miles away, the inspection may stop before it starts.

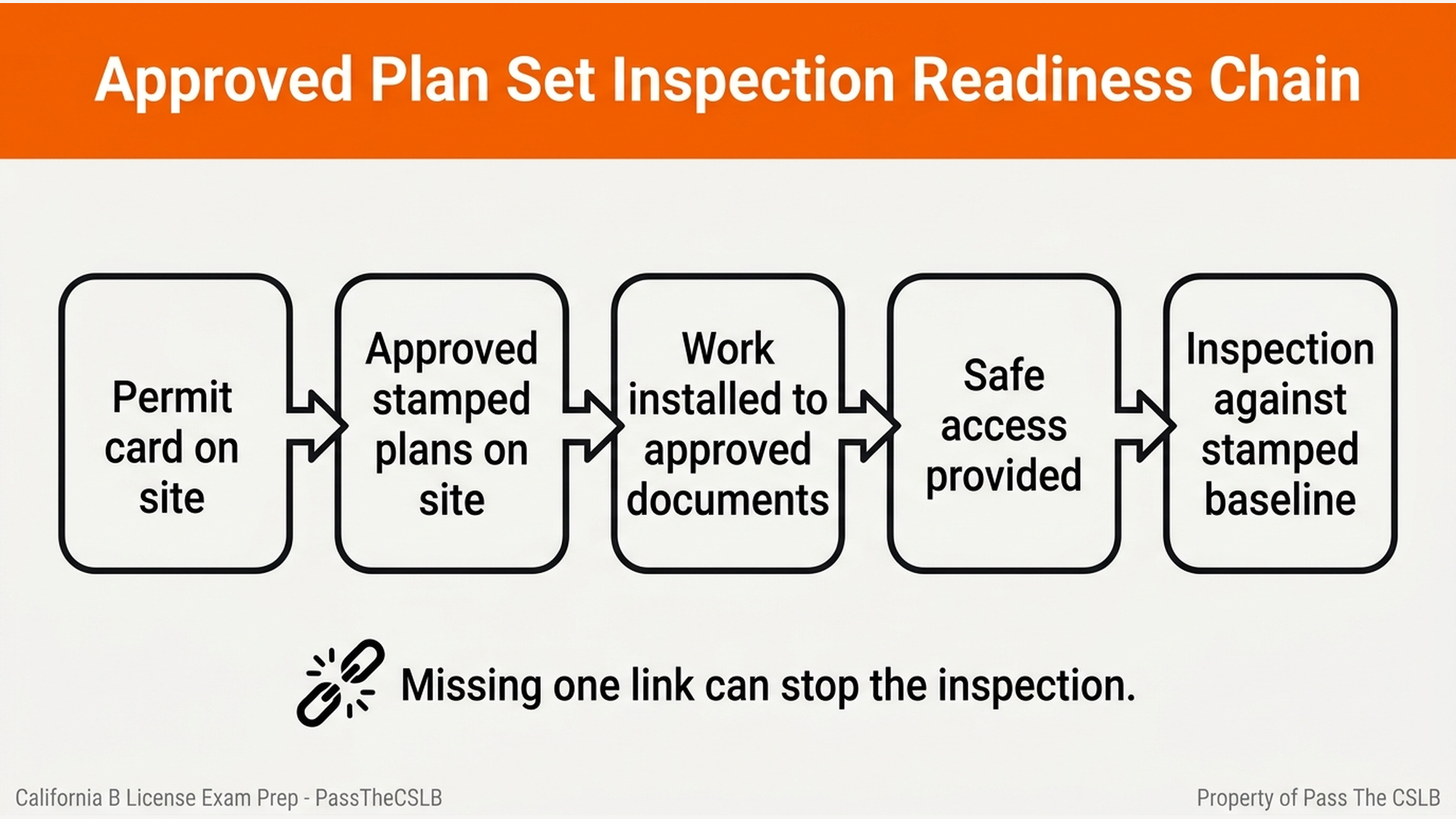

This chart shows the inspection readiness chain. Permit card on site. Approved plan set on site. Work installed to approved documents. Safe access provided. Inspection performed against the stamped baseline. Miss 1 link, and the chain breaks.
Here is the practical story. A superintendent schedules a shear wall inspection because the schedule is tight. The crew has the working set on a tablet, but the stamped plan set is in the truck of the project manager who is across town. The inspector arrives and asks for the approved plans. The superintendent says, I can show you the latest set. The inspector says, I need the approved set. That is not the inspector being difficult. Without the approved set, the inspector cannot verify whether the nailing, hold downs, panel layout, anchor bolts, and notes match what the authority approved.
That failed inspection is not just a fee. It can break the schedule, delay insulation, delay drywall, stack trades, and damage credibility with the owner. This is where paperwork becomes production. Control the golden set, and you control the inspection path.
My memory aid is simple. Card, plans, access. Card, plans, access. The permit card proves permission. The approved plans prove the scope. Access lets the inspector verify the work. Card, plans, access.
Now I want to get into field changes. Construction is full of surprises. A concealed beam is bigger than the plan assumed. A buried condition changes the footing layout. A product is unavailable. A wall conflicts with a required clearance. Experienced contractors solve problems every day. But the code draws a hard line between solving a problem and changing the approved design without approval.
California Building Code Section 107.4 gives the controlling rule. Work must be installed in accordance with the approved construction documents. Changes made during construction that are not in compliance with the approved construction documents must be resubmitted for approval as an amended set of construction documents.
That rule is not anti contractor. It is pro public safety. California has seismic risk, wildfire risk, energy requirements, accessibility requirements, and complicated agency overlays. A small field change can move load, change a fire separation, reduce an egress width, affect accessibility clearance, or break an energy compliance assumption. The person who notices the problem may not be the person legally responsible for redesigning the solution.
Here is the boundary I want you to remember. The contractor controls coordination and execution. The registered design professional controls the design when design is required. The authority having jurisdiction controls approval. That boundary keeps everyone in the right lane.
If a structural column conflicts with a corridor, I do not quietly move the wall and call it close enough. I pause the affected work. I document the conflict. I send a request for information to the architect or engineer in responsible charge. The design professional revises the affected sheets if needed. The change goes back to the local authority for review as an amended set. Only after approval should the stamped revised documents replace or update the jobsite set.
This is where the verbal okay fallacy gets people in trouble. A field conversation can be useful. An inspector may give practical direction. A designer may agree. An owner may approve the cost. None of that automatically replaces the requirement for amended approved documents when the change is not in compliance with the approved set. If the change touches structure, egress, fire resistance, accessibility, energy compliance, or other regulated design assumptions, the safest exam prep answer is to stop the affected work and obtain proper approval.
The same distinction applies to as builts. As built drawings are records of what exists after construction. Amended construction documents are approval tools for a change before or during construction. Do not swap those ideas. Building first and redlining later is not the code process for an unapproved substantive change.
Now I want to explain revision clouds and delta symbols, because they seem like drafting trivia until you understand what they do for the building department. A revision cloud is a scalloped line around the specific part of the drawing that changed. A delta symbol is the small triangle or revision marker tied to the title block revision history. Together, they tell the reviewer where to look and what changed.

This chart shows the clean field revision path. The conflict is found. The affected work pauses. The request for information goes to the design professional. The revised sheet is clouded around only the changed area. The delta symbol identifies the revision. The amended set is submitted to the authority having jurisdiction. The approved revised sheet is slip sheeted into the jobsite golden set.
I like the noise canceling headphone analogy. A large plan set is noisy. It has hundreds of lines, notes, dimensions, schedules, and details. When a plan checker receives a revision, that reviewer cannot spend unlimited time hunting for mystery changes. The cloud focuses the reviewer's eyes on the changed work. The delta tells the reviewer which revision event they are looking at.
That is why clouding the entire sheet is a bad habit. It looks safe, but it destroys the filter. If the entire sheet is clouded, the reviewer has to compare everything. That can slow review, trigger rejection, or create distrust. A good cloud is honest and specific. It wraps only the changed geometry, note, schedule, or detail.
Slip sheeting is the jobsite housekeeping step that keeps the golden set current. When the amended sheet is approved, the outdated sheet should be replaced, voided, or controlled according to the local process so the inspector is not forced to choose between conflicting sheets. The inspector should see 1 current approved story, not a stack of competing versions.
The memory aid here is cloud, delta, log, stamp, sheet. Cloud the change. Delta the revision. Log it in the title block. Get the approval stamp. Sheet it into the approved jobsite set. Cloud, delta, log, stamp, sheet.
I also want you to appreciate why California plan control is more layered than a simple national code answer. California uses Title 24, and different state agencies can regulate different occupancies and systems. Housing agencies, fire officials, school authorities, hospital authorities, local cities, and counties can all be part of the larger code landscape.
For a General B contractor, the lesson is to respect the approved plan set because it is where those layers have already been sorted for that project. On 1 job, a residential rule may dominate. On another, fire requirements may control. On another, accessibility may drive layout. The stamped plans are the project specific answer.
Factory built housing is a good example of overlapping authority. The state approved plans for the factory built unit can remain valid for 36 months from plan approval under the state rule identified in the source material, while the local authority still reviews and inspects site built components such as foundations, utility tie ins, garages, decks, and site assembly. The contractor has to know which approval path controls each part. That is coordination, not guesswork.
This is also why I do not want you to invent local timelines or local submittal quantities unless the local authority gives them. 1 city may ask for physical sets. Another may use a digital portal. One may require a comment response letter. The statewide principle is stable: changes that do not comply with the approved documents must be resubmitted for approval as amended documents. The local mechanics can vary.
Let me tie this back to estimating. Permit scope affects price. If the owner asks for work outside the approved scope, that may mean design fees, plan check time, additional inspection, schedule float, and possibly change order language. A contractor who prices only the physical labor but ignores revision control is underestimating the job. The paperwork path is part of the work path.
It also connects to safety. A field change can remove a brace, shift a load, narrow a path, compromise fire blocking, or alter a rated assembly. The approved plan process catches those effects before they are buried. Concrete covers embeds. Drywall covers framing. The inspection and approval process keeps hidden work from becoming hidden risk.
Here is the clean exam prep review I want you to carry with you. A permit authorizes a defined scope. Exempt from permit does not mean exempt from code. The approved stamped plan set is the legal baseline. The permit or a copy stays on site until completion. The approved construction documents stay at the work site and remain open to inspection. Work must follow the approved documents. If the field condition requires a change that does not match the approved set, the change must be resubmitted and approved as amended construction documents before it becomes the controlling field instruction.
If you remember only 1 image, remember the golden set in the plan box. The inspector is not inspecting against memory, habit, or good intentions. The inspector is inspecting against the approved documents. If you remember only 1 phrase, make it this. No permit required does not mean no rules apply. If you remember only 1 process, make it this. Pause, document, design response, resubmit, approve, slip sheet, then proceed.
There is an audio practice quiz for this specific episode, and I made it for the way real contractors study. It is audio based. The questions are read aloud, and you answer by tapping, so you can use it when you are studying on the go, between jobsite tasks, or after a long day when reading another page sounds impossible. Go to the description below this video. You will see a link that says PassTheCSLB. Tap it. It will take you straight there. And if anything I covered today felt unclear, comment below with your question. I read those because I want to know where the confusing spots are. Subscribe so I can help you stay on track through every episode until you get your license.
